How to Track Equipment in the Drylog on the mobile app?

The Equipment section records where equipment is placed, when it was installed, and when it was removed, providing a complete timeline of drying setup.

 What is Drylog Equipment?

The Equipment section records where equipment is placed, when it was installed, and when it was removed, giving you a complete timeline of your drying setup.

It tracks where drying equipment is placed, not just which equipment exists. It answers:

  • What equipment is on site?
  • Where is it located?
  • When was it placed?
  • When was it removed?

Adding Equipment

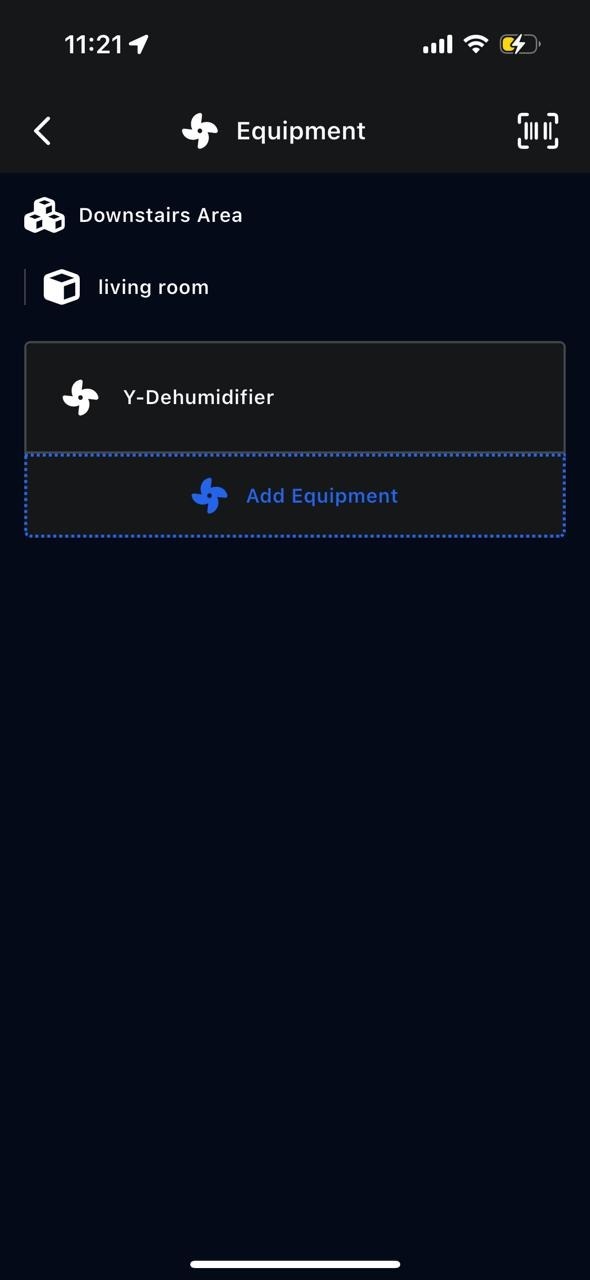

  1. Open Equipment.
  2. Select a chamber and room.
  3. Tap Add Equipment.
  4. Choose the equipment item. As you tick items, the recommendation tiles for the target room and chamber update straight away, so you can see whether you have met the recommendation before you save. If ticking takes the room or chamber past its previous highest point, the headline figure moves with it. Ticking an air mover will not move the dehumidification count, and vice versa — each item counts toward its own equipment type.

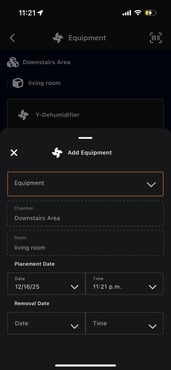

  5. Confirm:
    • Placement date
    • Placement time
  6. (Optional) Enter removal date and time.
  7. Save.

This creates a time-stamped placement record for each piece of equipment. The tiles refresh when you land back on the equipment page.

Note: Equipment already placed in the room you have selected is left out of the list, because picking it again would not change anything. Equipment in use on another project still appears, but Albi will ask you to confirm before reassigning it.

 Note: Equipment marked as removed lowers the currently placed figure on the tile, but not the headline figure. The headline is the most equipment that was on site at one time, so a tile does not go back to amber or red after a demobilisation.


Moving Equipment

Use the Move Equipment sheet to relocate a unit that is already placed.

While the move is in progress, the destination's recommendation tile counts the unit as though it were already there, so you can see the effect before committing to it. Nothing is saved until you save.

  • Cancelling the move leaves everything as it was.
  • Choosing the room the unit is already in will not count it twice.

Equipment Recommendations

Albi calculates how much drying equipment the affected areas call for, following the IICRC S500 standard, and shows the result on tiles throughout the app. There are two separate recommendations:

  • Air movers — calculated per room
  • LGR dehumidification — calculated per chamber

The recommendations appear in three places: the mobile app, the web Drylog, and the printed Drylog report. Albi calculates the numbers once and shows the same result everywhere, so all three always agree for the same Drylog.

Note: These are recommendations, not limits. Albi will never stop you placing fewer or more units than recommended. The tile only reports what the standard calls for against what you have placed — the final call is yours, based on what you are seeing on site.

Where the Tiles Appear

Where Which tiles
A room's Moisture Points and Equipment page That room's air movers, and its chamber's dehumidification
The Drylog Equipment list Air movers per room, dehumidification per chamber
Select Equipment, the picker used when adding The target room and chamber, updating as items are ticked
Move Equipment sheet The chamber and room currently selected as the destination

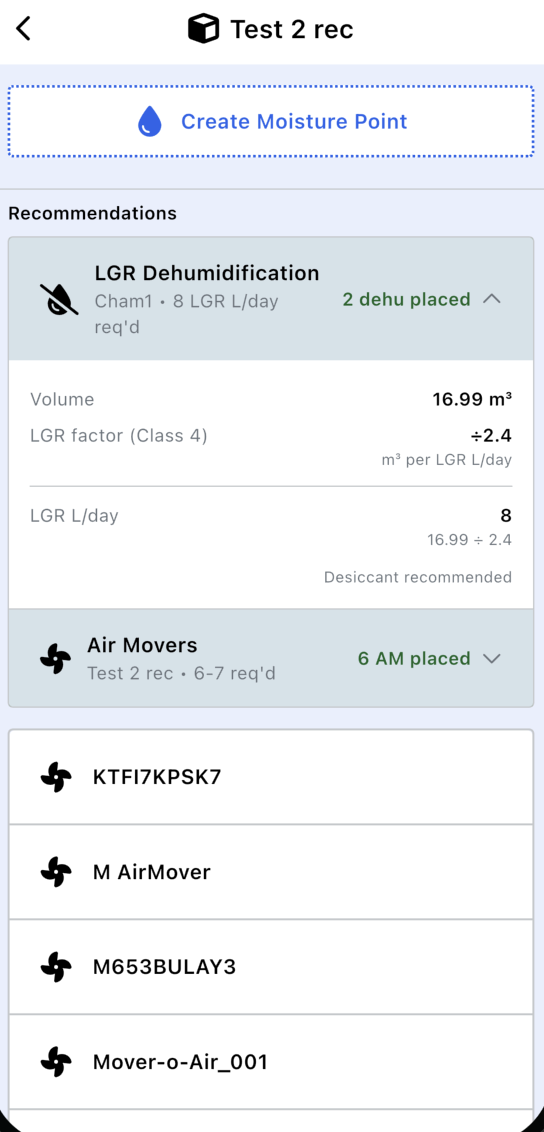

image-20260806-221852

Reading a Tile

A collapsed tile shows the equipment type, then the room or chamber name followed by what is required and how many are currently placed, then a headline figure, then a status colour.

The headline figure is the most of that equipment type that were on site at one time. The currently placed figure sits in the subtitle beside the requirement and is always shown, even while the two match, so you can watch it move as you tick each unit. A note under the tile reads "Reflects equipment placed for more than 30 minutes".

Colour Air movers Dehumidification
Red Nothing placed Nothing placed
Amber Some placed, but fewer than the low end of the range Not used
Green The low end of the range is reached or passed At least one placed

Air movers show a range, for example "7-10 reqd", unless the low and high ends happen to be the same, in which case you will see a single number.

Note: Green means you are inside the recommended range, not at the top of it. A room recommending 7-10 air movers turns green at 7. Anything from 7 upward meets the standard.

 Note: The colours are judged against the headline figure, not the live count. A finished job with everything picked up still reads green, because the requirement was met while the job was running.

Tap any tile to expand it and see every figure behind the number, so you can justify the count to an adjuster without redoing the arithmetic by hand.


The Placed Count Is the Job's Peak

A recommendation answers one question: was the drying equipment the standard calls for actually put in? A live count cannot answer that once the job is over — equipment is picked up at demobilisation, the count falls to zero, and the tile reads as though the recommendation was never followed.

The headline figure on a tile is therefore the most equipment that was on site at one time during the job. The live count is still there, in the subtitle next to the requirement.

Rule What it means
The most at one time Not the total that passed through. Three air movers swapped for three others still reads 3.
One unit counts once The same dehumidifier placed, removed and placed again is one unit, not two.
Equipment on site always counts However recently it was placed. The figure can never read lower than what is in front of you.
Under 30 minutes and gone does not count A unit placed and picked up again inside 30 minutes is treated as a mis-tap, so an accidental add does not inflate the figure.
Back-to-back stays join up Two 20-minute stints of the same unit with no gap between them are one 40-minute stay, so together they clear the 30-minute mark.

Nothing needs setting up. The figure comes from placement history Albi already records, so it applies to older jobs as well as new ones.


How Air Movers Are Calculated

Component Imperial Metric
Room baseline 1 per room 1 per room
Floor air movers low = affected floor ÷ 70
high = ÷ 50
low = ÷ 6.5
high = ÷ 4.5
Wall and ceiling air movers low = (affected wall + ceiling) ÷ 150
high = ÷ 100
low = ÷ 14
high = ÷ 9.3
Offsets and insets +1 each +1 each

Every division rounds up to the next whole air mover. Three details account for most of the "that number looks wrong" questions:

  • The bottom of every wall is excluded. Air movers dry the upper wall, so Albi leaves out the bottom 2 ft in imperial, or the bottom 60 cm in metric. The tile labels this "Affected wall above 2 ft".
  • Wall and ceiling are added together before dividing, not calculated separately and then added. Dividing them separately rounds up twice and gives a higher number than Albi shows.
  • Each offset or inset adds one air mover. These are recesses deeper than 18 in (45 cm) — alcoves, bays and closet openings — because air will not turn the corner into a recess on its own. Recesses shallower than that should not be counted, since counting them inflates your recommendation.

image-20260806-222140



Note: Floor area, ceiling area, wall area and wall length are always calculated from the room's dimensions or its sketch, and cannot be edited directly. To change them, change the dimensions or the sketch. Only the affected percentages and areas are typed in by hand.

Very Small Rooms

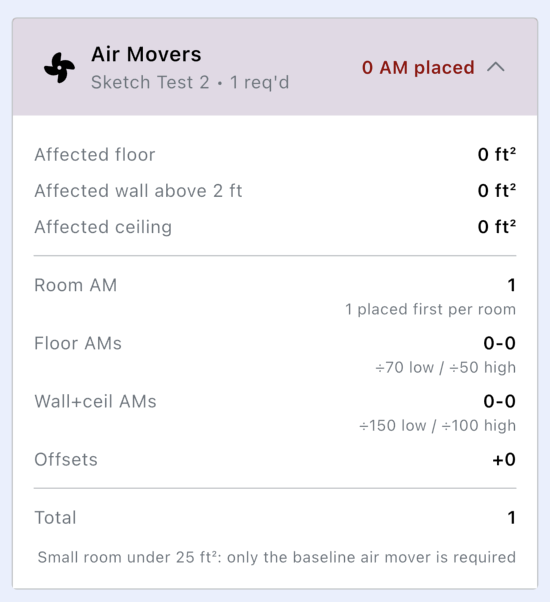

A room with a floor area under 25 ft² (2.3 m²) will only ever recommend the single baseline air mover, whatever the surfaces work out to — a closet does not need four air movers. The expanded tile shows a note explaining this, so the surface figures above it are shown but not counted.

image-20260812-205455

How Dehumidification Is Calculated

This recommendation is per chamber, not per room, because a chamber is dried as one air space. Albi adds up the volume of every room in the chamber, then divides by a factor for the chamber's water class and rounds up. The result is shown in pints per day (imperial) or litres per day (metric).

That is the simple method, which is the default. Albi also supports the S500's detailed method, which sizes dehumidification from the building's conditions as well — see The Detailed Method below.

Note: Albi counts units, not capacity. One dehumidifier turns the tile green even when the chamber requires 38 pints per day, because Albi cannot tell whether the unit you placed actually delivers that. Matching capacity to the requirement is still up to you — a green tile confirms something is placed, not that it is big enough.

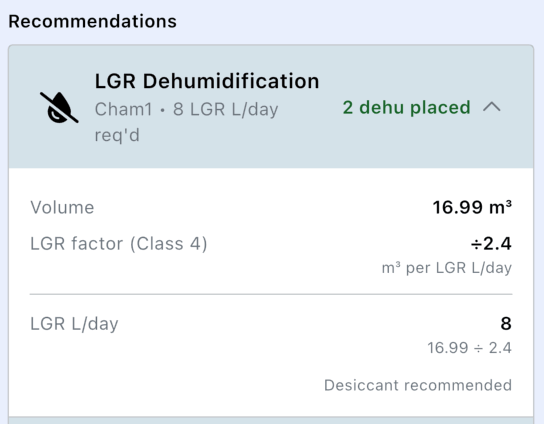

image-20260806-221939

Automatic Water Class

A chamber's water class can be set manually or left on Auto. On Auto, Albi derives it from how much of the chamber's surface area is affected: for every room it adds up the affected floor, ceiling and wall areas, divides by the total surface area of the chamber, and reads the class off that percentage.

Affected surface area Class on Auto
Under 5% Class 1
5% to 40% Class 2
Over 40% Class 3
Not applicable Class 4 is a manual selection only, and is never chosen automatically

Exactly 5% and exactly 40% both read as Class 2 — the boundaries belong to the middle band.

Two things about Auto are worth knowing:

  • The percentage is chamber-wide, not per room. A large dry room dilutes a small soaked one. The same soaked room can land a chamber on Class 3 next to one dry room of equal size, or Class 2 next to nine times as much dry surface.
  • Auto never picks Class 4. Even a chamber that is 100% affected everywhere derives Class 3, because Class 4 describes deeply held moisture in materials like hardwood, plaster and concrete, which cannot be read off areas and percentages. Choose it manually if the job calls for it.

If a chamber has no rooms, or its rooms have no dimensions yet, Auto has nothing to classify. The chamber then has no class, no dehumidification tile, and no dehumidification block in the report. It resolves as soon as a room gets dimensions, or you choose a class manually.

The class selection keeps reading Auto; what it resolved to shows wherever the class is used. Any edit to a room's dimensions or affected areas re-derives it immediately. Setting a manual class stops the movement.


The Detailed Method

The IICRC S500 sizes LGR dehumidification two ways. The simple method divides the chamber volume by a water class factor. The detailed method divides by a base AHAM figure instead, then scales the result with multipliers for the water class and the building's conditions, so the answer reflects the actual structure being dried.

It is one switch per Drylog, off by default. When it is on, it applies to every chamber in that Drylog.

Note: The detailed method only ever changes dehumidification. Air mover recommendations never move with it, whatever you select.

Where to Find It

In the mobile app there is a Detailed Method button in two places:

  • At the bottom of the site information page
  • At the top of the equipment page

The button reads "Simple method · Tap to configure" when the detailed method is off, and shows the active multiplier, for example "1.65× multiplier active", when it is on. Either button opens the configurator, which holds the toggle, the five condition sections and a live breakdown.

Note: Nothing persists until you tap Save.

The Five Building Conditions

Every option carries its multiplier, shown beside it in the dropdowns. An option you have not set counts as a neutral ×1.0.

Build-out density Multiplier Meaning
Very open ×0.6 Factory, warehouse, box store or theatre
Fairly open ×0.8 School or open concept office
Average ×1.0 Most homes or hotels
Dense ×1.2 Medical office or closed office space
Building construction Multiplier Meaning
Standard finishes ×1.0 Builder-grade wood or vinyl finishes
High-end finishes ×1.5 Architectural-grade panelling, insulation, wood trim
 Will HVAC Support Drying  Multiplier Meaning
Yes ×1.0 HVAC system is present and operating
No ×1.3 System not present, or not operable

Weather and envelope only carry a factor as a pair. The prevailing weather is Favorable (aids drying, under 40 GPP or a 43°F dew point), Neutral (40 to 60 GPP) or Unfavorable (hinders drying, over 60 GPP). The building envelope is Tight (outdoor conditions cannot enter), Moderate (lets some in) or Loose (not protected from the outdoors).

Envelope Favorable Neutral Unfavorable
Tight ×1.0 ×1.0 ×1.2
Moderate ×0.9 ×1.1 ×1.4
Loose ×0.8 ×1.2 ×1.6

A favorable climate on a loose building can genuinely reduce the requirement, at ×0.8 or ×0.9, because the outside air is helping the dry.

When the site has no stored value for a section, the configurator preselects the neutral option: Average, Standard finishes, Yes, and the Neutral and Tight pair. All of those are ×1.0.

How the Calculation Works

The four condition factors multiply into the conditions multiplier, which is site-wide — every chamber shares it. Each chamber then multiplies in its own class factor: ×1.0 for Class 1, ×1.5 for Class 2, ×2.0 for Class 3 and ×2.3 for Class 4. A chamber on Auto uses the factor for whichever class it derived.

The combined multiplier is the conditions multiplier × the class factor. Required capacity is then the chamber volume ÷ 70 (the base AHAM divisor, or 4.2 in metric) × the combined multiplier, rounded up.

Note: Under the detailed method the class stops being a divisor and becomes a multiplier. This is why all-neutral selections do not reproduce the simple method's number — it is different arithmetic, not the same sum with different inputs.

Why You See Two Different Multipliers

The configurator, its button and the page header show the conditions multiplier, the part every chamber shares. The dehumidification tile and the report show the combined multiplier, which is the conditions multiplier × that chamber's class factor.

If you see ×1.65 on the button and ×2.48 on a tile, you are looking at the same settings — once without the chamber's class, and once with it.

Shared With the Site Information

Weather, envelope, density and construction are the same stored values as the building section of the site information, so editing either place edits both. Will HVAC Support Drying exists only in the configurator.

If you open the configurator while the site form is holding building picks you have not saved yet, the configurator previews those picks. They persist only when one of the two forms is saved.

Note: Turning the detailed method off keeps your selections. They simply stop being applied, and the numbers return to the simple method.

Some Options Were Renamed

The dropdowns changed when the multipliers arrived, and stored selections were remapped once rather than cleared. Under build-out density, "Fairly dense" is now Dense, and Very open is new. Under building construction, "Poor" and "Average" are now Standard finishes, and "Good" is now High-end finishes. If you notice an old selection appearing under a new name, this migration is why.

Recommendations in the Drylog Report

The Drylog report prints the same recommendations as the tiles, worked out fresh at the moment the report is generated. Each chamber's pages carry a Dehumidification block with the full calculation breakdown and the equipment placed, and the rooms table gains AMs Req'd and AMs Placed columns with the same status dots as the tiles. Each room's pages carry an Air Mover Calculation block mirroring the expanded tile.

The placed figures in the report are the same headline figures as the tiles — the most equipment that was on site at one time, not a live reading. The report labels them so they are not mistaken for one:

  • The chamber's dehumidifier list sits under a "Max equipment placed (N)" heading, and the units listed beneath it are the ones that made up that figure. The heading and the list always agree, even for a chamber whose dehumidifiers were swapped mid-job.
  • The AMs Placed column in the chamber rooms table is marked (max).

A company can also choose to leave the recommendation content out of the PDF altogether. That setting, and everything else about generating a report, is covered in the Drylog reports article.

Note: The report is a snapshot. It prints what the Drylog contains at the moment it is generated, so if rooms, classes, placed equipment or the detailed method change afterwards, an already-generated PDF keeps the old numbers. Generate a new report to refresh them.


Generating a Report from the App

The Generate Drylog Report sheet now offers the same four options as web: which equipment recommendations to include, how the equipment tables are ordered, whether timestamps are printed, and how visits are counted. The last two of those are new to mobile.

The options are pre-filled from your company's Drylog settings, which are set on web under Settings, Project, Drylog. Anything you change in the sheet applies to that one PDF and does not change the company setting.

Note: The sheet loads the company settings when it opens. If it is showing an option you have since changed, close and reopen it. If the device is offline it falls back to the standard defaults rather than blocking the sheet.


Mobile and Web Show the Same Numbers

Albi calculates the recommendations once and shows the same result in the mobile app, the web Drylog and the report, including the placed figures.  If you are seeing different numbers on the two, one screen is showing older data — leave and re-enter the equipment page on mobile, or reopen the page on web.

For the full worked examples, the detailed method's worked example, and the complete list of what changes a recommendation, see the web version of this article.


Frequently Asked Questions

The report says 5 air movers placed, but the job is finished and nothing is on site.

Working as intended. The figure is the most equipment that was on site at one time during the job. The live count is still printed beside the requirement, and reads 0 currently placed.

A dehumidifier went in ten minutes ago and it is already counted. Isn't there a 30-minute rule?

The 30-minute rule only excludes equipment that was picked up again within 30 minutes. Anything still on site counts straight away.

A fourth air mover was added and the count did not go up.

Expected if the room had already reached a higher point earlier in the job. The headline only moves when the current number passes it — the currently placed figure beside the requirement will have gone up.

Six air movers were swapped out mid-job. Why does it say 3 and not 6?

Because three were on site at any one time. The figure answers "was the recommendation met", not "how many units passed through".

The report sheet is showing an old setting.

It loads the company settings when it opens. Close and reopen it. If the device is offline it falls back to the standard defaults.

My room is asking for far too many air movers.

Tap the tile to expand it. Usually one of two things is happening: the affected percentages are still at 100% for all three surfaces when only part of the room is actually wet, or the offsets counter has been used for shallow recesses. Both will raise the count legitimately.

Why is there a range instead of one number?

The standard gives a range per square foot of affected surface, so Albi shows both ends. The low end is the minimum that meets the standard; the high end dries faster. Anything within the range is compliant.

When exactly does the air mover tile turn green?

When the most on site at one time reaches the low end of the range. A 7-10 room is green at 7, and stays green afterwards even once the equipment is picked up.

A closet is only recommending one air mover. Is that right?

Yes. Rooms under 25 ft² (2.3 m²) only recommend the single baseline unit, and the expanded tile shows a note saying so.

The wall figure looks smaller than I expected.

The bottom 2 ft (60 cm) of every wall is deliberately excluded, since air movers are drying the upper wall. The tile labels this "Affected wall above 2 ft".

What counts as an offset or inset?

A recess deeper than 18 in (45 cm) — an alcove, bay or closet opening. Each adds one air mover. Shallower recesses should not be counted.

The placed count went up before I saved anything.

That is expected. Ticked items in the picker, and the destination of a move in progress, are counted live so you can see the result before saving. Nothing is stored until you save.

Some equipment is missing from the picker.

Equipment already placed in the target room is hidden on purpose, since picking it again would not change anything. Equipment in use on another project still appears, but will ask you to confirm before it is reassigned.

I turned the detailed method on and every chamber's number jumped.

That is expected. The divisor changes from the class factor to the base AHAM figure of 70 (4.2 in metric), and the water class and building conditions come back in as multipliers. Even all-neutral selections give a different number, because it is different arithmetic.

The button says ×1.65 but the tile says ×2.48.

Both are right. The button shows the conditions multiplier, which every chamber shares. The tile multiplies in that chamber's class factor on top of it.

I enabled the detailed method on one chamber. Is it on for the others?

Yes. It is one Drylog-wide setting. Only the class factor varies per chamber.

Air movers did not change after I turned the detailed method on.

They never do. The detailed method only refines dehumidification.

My saved density or construction option is gone.

It was renamed, not cleared. "Fairly dense" is now Dense, "Poor" and "Average" are now Standard finishes, and "Good" is now High-end finishes.

A chamber is soaked everywhere but Auto shows Class 3, not Class 4.

That is correct. Auto never selects Class 4, because Class 4 describes deeply held moisture in materials that cannot be read off areas and percentages. Choose Class 4 manually if the job calls for it.

I do not see a dehumidification tile at all.

The chamber has no water class resolved yet, so there is nothing to calculate from. Set a class, or give the chamber rooms with dimensions so Auto can derive one.


Related Articles Still Need Help?

If you have questions or run into an issue, contact Albi Support and we will be happy to help.
